Written by the gas storage engineering team at Sichuan Mondes Green Technology Co., Ltd., the manufacturer of the FS-series biogas holders we build and export. Last updated September 2026. This guide separates the two products behind one loose word, shows how to size the buffer, and lists the five numbers that separate a good quote from a bad one, drawn from jobs we have actually built.

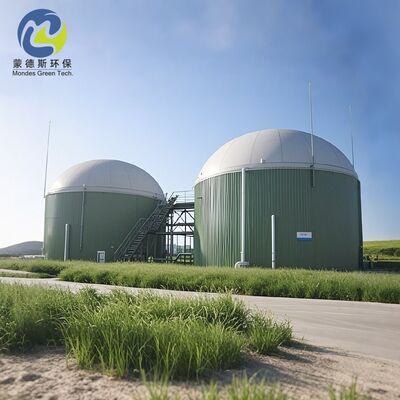

A biogas balloon is a flexible, gas-tight membrane envelope used to store biogas (or other low-pressure gases) above or beside an anaerobic digester. Unlike rigid steel vessels that hold gas under pressure, a balloon stores it at near-atmospheric pressure, using the membrane's own shape and a small air cushion to keep the volume stable.
The word "balloon" is loose on purpose. It covers two products that could not be more different in price and capability: a single-skin bag and an engineered double-membrane holder. Buyers routinely confuse them. The rest of this guide is about telling them apart before you pay.
A single-skin balloon is one gas-tight fabric envelope, welded shut, resting on a slab or inside a frame. Gas goes in, the bag swells, gas comes out. Nothing holds a set pressure, and the fabric itself is the only barrier between your methane and the weather.
A double-membrane biogas balloon adds a second skin over the first, and a small explosion-protected blower pumps air into the gap between them. That air cushion holds the outer skin in a stable dome shape and pushes down on the gas side so the outlet pressure stays within a narrow window, typically 2 to 20 mbar, around the clock.
A biogas balloon is a buffer between two clocks: the digester produces gas 24 hours a day, and your equipment consumes it on its own schedule. The volume exists to cover the gap between those clocks. The calculation is one line:
Buffer volume (m³) = hourly gas production (Nm³/h) × hours of autonomy you needThe hours of autonomy depend on what sits downstream:
A worked example. A digester makes 250 Nm³/h of raw biogas. Feeding a continuous CHP, it needs 250 × 6 = 1,500 m³ of buffer. Feeding a CNG plant that fills trucks during one day shift, it needs closer to 250 × 16 = 4,000 m³. Same plant, same digester, nearly three times the balloon.
Quotes arrive as one-page PDFs with a volume and a price. The information you actually need is on the membrane datasheet and the control specification. Ask for these five numbers before you compare:
Each one below has reached us as a rescue request, sometimes years after the original order went in.
The plant looked balanced on paper in July. By December, production was down a quarter, the CHP was starved by 4 a.m., and the flare was quietly billing the owner for the difference. Re-running the buffer calculation on the weakest month costs nothing before you order.
Raw biogas with H₂S above roughly 500 ppm attacks coating systems, fouls sensors, and ages the membrane faster. If your feedstock is poultry litter, slaughterhouse waste, or anything sulfur-rich, desulfurization belongs in the same project as the balloon, not next year's wish list.
The membrane is maybe half the delivered cost. The anchor ring, support blower, control cabinet, relief valves, condensate drains, level sensing, freight, and the concrete slab make up the rest. Quotes that itemize only the balloon are not cheaper, they are incomplete.
What arrives: a double-membrane balloon ships folded in crates: the inner membrane, outer membrane, bottom membrane, anchor rails, blower, valves, and the control cabinet. Site preparation is a flat concrete slab with anchor bolts cast in (freestanding unit) or a gas-tight flange on the digester roof (mounted unit).
How long: for a mid-size unit (say 500 to 1,500 m³), a practiced crew unloads, anchors, unfurls, and clamps the membranes in three to five working days. Commissioning adds pressure and leak tests and tuning the control window, typically another day. Compare that with field-welded steel, where the crane and welding teams measure their visit in weeks.
The monitoring trick: the support blower holds the air cushion at a set pressure. If its power draw creeps up week after week while gas production stays flat, air is escaping where it should not, usually past the inner membrane through a tired seam. Operators who log blower current monthly catch leaks while they are still a repair. The rest of the routine is short: a visual walk-around each month, draining condensate from the sump, and one annual inspection of seams and the anchor clamping line. Plan the inner membrane as a replacement item around year 10 to 15, and it is scheduled maintenance rather than an unplanned shutdown.
Sichuan Mondes Green Technology Co., Ltd. builds double-membrane biogas holders (the FS series) and the Glass-Fused-to-Steel digester tanks they sit on, so the roof and the tank are designed as one system instead of two suppliers pointing at each other.
Fabrication runs under an ISO 9001:2015 quality system, membranes are 100% high-frequency welded, and every unit ships with the fabric test data and a clamp-profile drawing for your tank crown.
We would rather tell you when a membrane holder is the wrong call than win a sale and lose a reference. If your duty is high-pressure, flame-exposed, or above the H2S ceiling, we will say so and point you to the right structure.
Send us your hourly gas production, downstream equipment, and site wind/snow data, and you will get a sizing calculation with the working shown, not a catalogue price per cubic metre. We manufacture the FS-series holder at Sichuan Mondes Green Technology (ISO 9001).
Email: richie@scmondes.comA 100 kW engine consumes roughly 50 to 60 Nm³ of biogas per hour. Running continuously, a 4 to 6 hour buffer means about 250 to 350 m³ of working volume. Daytime-only operation roughly doubles that. Start from your engine's datasheet, not a rule of thumb.
Boiler or kitchen gas on a farm: single-skin is the economical choice. Anything with an engine, compressor, or upgrading skid downstream: double-membrane, because those devices need constant supply pressure.
Volume, fabric grade, site loads, and package scope drive the number. Price per cubic metre falls as volume rises, and blower, valves, controls, freight, and foundation add a real share on small units. Compare complete packages only.
Yes. Specified membranes stay flexible from −30 to +70 °C. The pressurized dome sheds moderate snow. Heavy-snow regions need a higher fabric grade and a documented snow-load calculation for the site.
Track the support blower's power draw. A slow upward creep at steady production usually means gas or air is crossing the inner membrane. Confirm with a methane detector around the base and an annual seam inspection.
